What to Know Before Hiring Atlanta Pool Builders
Atlanta pool builders are specialists in designing and constructing custom inground pools โ most commonly gunite โ built to handle the regionโs unique soil, terrain, and climate conditions.
If youโre ready to hire, hereโs what matters most:
- Choose gunite โ itโs the most durable and design-flexible option for Atlantaโs clay-heavy soil

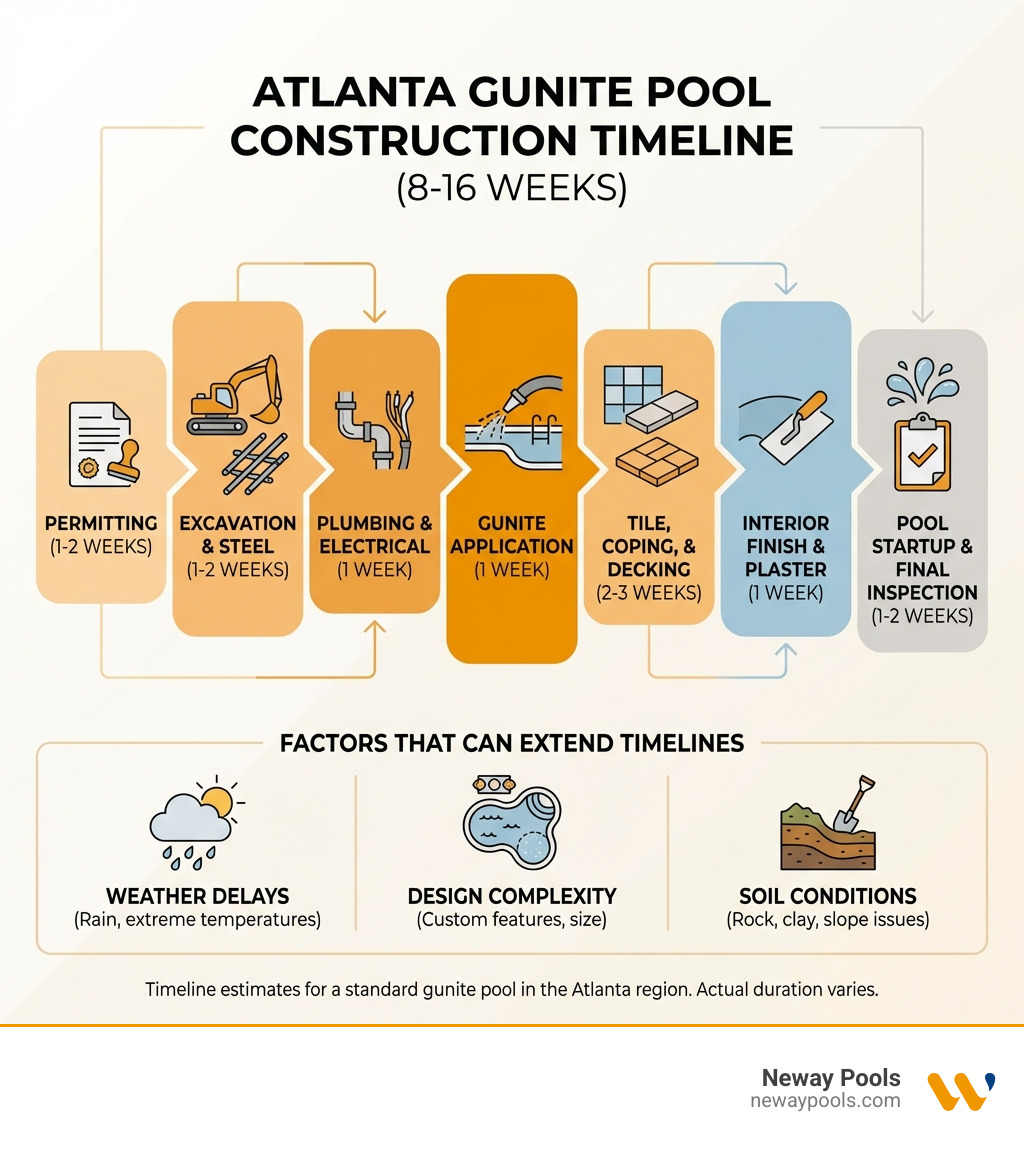

- Budget 8 to 16 weeks for construction, depending on design complexity and permitting
- Verify licensing and insurance โ confirm Georgia certification and liability coverage before signing anything
- Get 3 to 4 written estimates and compare warranties, timelines, and whatโs included
- Ask about local experience โ builders who know Atlantaโs soil, slopes, and permit process will save you time and money
Atlanta homeowners face real challenges when building a pool: clay soil that shifts, sloped backyards, underground rock, and a permit process that varies by county. The right builder knows how to handle all of it โ and will be upfront with you from day one.
Iโm Lucas Pimenta, General Manager at Neway Pools, and with over 20 years of hands-on experience building custom gunite pools โ including our Alpharetta, Georgia location serving the greater Atlanta area โ Iโve seen what separates a smooth build from a stressful one when working with Atlanta pool builders. This guide covers everything you need to make a confident, informed decision.

The Comprehensive Guide to Hiring Atlanta Pool Builders
Hiring a pool builder is a significant investment that changes how you use your home for decades. In the Atlanta metro area, from the busy streets of Buckhead to the quiet suburbs of Milton, the process involves much more than just digging a hole. It requires a partner who understands project management, site assessment, and architectural harmony.
A professional builder starts by analyzing your lifestyle. Will this pool be for high-energy kids, morning lap exercise, or sophisticated evening entertaining? By using a Guide to Building a New Pool in Georgia, you can see how custom drafting ensures your pool isnโt just a โtemplateโ dropped into a yard, but a seamless integration of your homeโs architecture and your personal aesthetic.
Why Atlanta Pool Builders Prioritize Custom Gunite
When we talk about high-end residential pools in North Georgia, gunite (a mixture of cement, sand, and water applied through a high-pressure hose) is the gold standard. Unlike vinyl liners or fiberglass shells, gunite offers unparalleled structural integrity and design flexibility.
The shotcrete or gunite application process creates a monolithic, reinforced structure that can be molded into any shape imaginableโfrom sleek, modern rectangles to naturalistic lagoons. This is particularly important for the โlifetime shellsโ that homeowners expect. Because gunite is built on-site with steel reinforcement, it handles the pressure of Georgiaโs heavy soil better than any other material. For those looking for more info about new pool construction, understanding the durability of gunite is the first step toward a successful project.
Vetting Professional Atlanta Pool Builders for Quality
Not all Atlanta pool builders are created equal. To protect your investment, you must perform due diligence. Start by verifying that your prospective contractor is licensed with the Georgia Registrar of Contractors and holds active liability insurance and workmanโs compensation.
Reputable builders will often be members of the Pool & Hot Tub Alliance (PHTA), which sets high industry standards for safety and construction. We always recommend asking for a 3D visualization of the project before any dirt is moved. This allows you to walk through your backyard virtually and catch potential design flaws. Whether you are looking for a Milton Pool Builder Georgia or a contractor in the heart of the city, checking recent references and visiting active construction sites is the best way to gauge real-world quality.
Navigating Regional Construction Challenges and Soil Conditions
Building in Atlanta presents a unique set of geographical hurdles. While our neighbors in Florida might deal with sandy soil and high water tables, North Georgia is famousโor perhaps infamousโfor its dense, red clay.
| Factor | Impact on Pool Construction |
|---|---|
| Clay Soil | Expands and contracts with moisture; requires heavy steel reinforcement to prevent shell cracking. |
| Sandy Soil | Common in some Southern regions; requires โshoringโ or plywood framing to prevent trench collapse during excavation. |
| Underground Rock | Common in areas like North Gwinnett and Cherokee; may require specialized โhammerโ equipment, increasing costs. |
| High Water Table | Requires hydrostatic relief valves to prevent the pool from โfloatingโ or lifting out of the ground. |
As a Cobb County Pool Builder, we often encounter underground obstacles like massive granite boulders or extensive tree root systems from mature oaks. Furthermore, utility line relocation is a frequent necessity in older Atlanta neighborhoods to ensure the pool footprint meets safety clearances.
Managing Sloped Backyards and Elevations
Atlanta is anything but flat. Many of the most beautiful homesites in areas like Peachtree Corners are built on significant slopes. While a steep backyard might seem like a dealbreaker, itโs actually an opportunity for dramatic design.
Professional Atlanta pool builders use structural engineering to create multi-level environments. This often involves:
- Retaining Walls: To level the ground and provide structural support for the pool shell.
- Vanishing Edges: Using the natural slope to create a โwaterfallโ effect where the pool seems to merge with the horizon.
- Drainage Solutions: Ensuring that rainwater from the uphill side of the property is diverted away from the pool and the homeโs foundation.
Permitting and Safety Regulations in Georgia
Navigating the bureaucracy of building permits can be a headache, but itโs a critical part of the process. In Georgia, safety is the primary focus of local codes. This includes:
- Safety Barriers: Most counties require a fence at least 4 feet high with self-closing, self-latching gates.
- Gate Access: Requirements for how far the latch must be from the ground to prevent small children from opening it.
- Zoning Variances: If your pool is too close to a property line or an easement, you may need to apply for a variance.
Always research local business ratings and reviews for any builder you consider to ensure they have a history of following these regulations and closing out permits properly.
Trending Features and Integrated Outdoor Living Spaces
Todayโs homeowners are looking for more than just a place to swim; they want a โprivate resortโ experience. Atlanta pool builders are seeing a massive shift toward minimalist designs and high-functioning โstaycationโ features.
One of the most popular trends is the addition of a sun shelf (also known as a tanning ledge). These shallow areasโusually only 6 to 12 inches deepโare perfect for lounge chairs, umbrellas, or for toddlers to splash safely. For those with limited space, modern luxury sun shelf ideas for small backyards in GA show how you can pack a lot of style into a compact footprint.
Custom Water and Fire Features
To create a sensory experience, we often incorporate water and fire. Rock waterfalls provide a natural look and the soothing sound of moving water, while deck jets create elegant arcs of water that dance into the pool. You can find more info about water features to see how they can be customized with LED lighting to change the mood of your backyard at the touch of a button.
Fire features are equally transformative. Fire pits or fire bowls positioned near the waterโs edge create a stunning reflection and extend the usability of your outdoor space into the cooler Georgia autumn nights. If you are looking for inspiration, a Berkeley Lake Pool Builder GA can show you how these elements work together to create a cohesive nightscape.
Luxury Outdoor Kitchens and Cabanas
The pool is often the centerpiece, but the surrounding โliving roomsโ complete the vision. We specialize in designing entire outdoor environments that include:
- Premium Grills: High-performance appliances that make outdoor cooking a joy.
- Custom Cabinetry: Weather-resistant materials that provide storage and style.
- Cabanas and Pavilions: Providing much-needed shade from the Georgia sun and a place for al fresco dining.
Consulting an Alpharetta GA Pool Builder about these integrated spaces during the initial design phase ensures that your gas, water, and electrical lines are all run correctly from the start, saving you thousands in future renovation costs. Check out these outdoor kitchen design ideas for more inspiration.
Financing and Protecting Your Backyard Investment
A custom gunite pool is a significant financial commitment. Fortunately, there are several ways to make the project more accessible. Many homeowners opt for personal loans or specialized pool financing that doesnโt require home equity.
Platform loans, such as those offered by HFS Financial, fund 100% direct-to-consumer and often perform only a soft credit check to present your options. You can read HFS Financial loan reviews to see how other homeowners have managed their projects. Itโs also vital to budget for potential โunforeseens,โ such as hitting rock during excavation, which is a common occurrence for Atlanta pool builders. Explore our pool financing options to see what fits your familyโs budget.
Warranty Standards for Equipment and Hardscapes
A reputable builder stands behind their work. When comparing Atlanta pool builders, look for a โLifetime Structural Warrantyโ on the gunite shell. This ensures that the core of your pool is protected for as long as you own the home.
At Neway Pools, we provide a 3-year warranty on hardscapes and plumbing, which is a significant step above the industry standard. This covers everything from the stone coping around the edge to the intricate pipework underground. When talking to Pool Builders Cumming GA, always ask for their specific workmanship standards in writing to ensure you are getting the quality you pay for.
Frequently Asked Questions About Atlanta Pool Construction
How long does it take to build a pool in Atlanta?
While a simple project might take 8 to 10 weeks, most custom gunite builds in Atlanta range from 8 to 16 weeks. Factors like the permitting speed in your specific county (like Gwinnett vs. Fulton), weather delays (especially during our rainy springs), and the complexity of your hardscaping can all impact the final timeline.
What is the average size required for an inground pool?
Typically, you need at least 500 square feet of clear backyard space for a standard inground pool. However, creative Atlanta pool builders can design โspoolsโ (small pools) or plunge pools for much tighter lots, provided we can maintain the required setbacks from property lines and septic systems.
Can I build a pool on a steep slope?
Absolutely. In fact, some of the most stunning pools in Georgia are built on hillsides. By using retaining walls, structural piers, and advanced engineering, we can create a level oasis on even the most challenging terrain. This often allows for features like infinity edges that wouldnโt be possible on a flat lot.
Start Your Backyard Transformation
Building a pool should be an exciting journey, not a stressful one. By choosing a builder with deep regional expertise and a commitment to premium materials, youโre ensuring that your new backyard will be a source of joy for decades to come.
At Neway Pools, our General Manager Lucas Pimenta and our entire team are dedicated to crafting inspiring spaces that bring families together. Whether youโre in Marietta, Sandy Springs, or Johns Creek, weโre here to turn your vision into a reality. Donโt forget to check out our End of Year Pool Specials Georgia to see how you can maximize your investment.
Ready to dive in? Contact us to start your design and letโs build something incredible together.
